Job
No.: TCS00975/18 |
|
|
||
|
|
|
|
|
||
|
|
CEDD Contract Agreement No.
EDO/04/2018 - Environmental Team for Cross Bay Link, Tseung Kwan O |
|
|
||
|
|
|
|
|
||
|
|
Quarterly Environmental
Monitoring and Audit (EM&A) Summary Report (June to
August 2020) |
|
|
||
|
|
Prepared For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Date |
Reference No. |
Prepared By |
Certified By |
20 October 2020 |
TCS00975/18/600/R0461v2 |
|
|
Martin Li (Environmental
Consultant) |
Tam Tak Wing (Environmental
Team Leader) |
Version |
Date |
Remarks |
1 |
22 September 2020 |
First Submission |
2 |
20
October 2020 |
Amended against

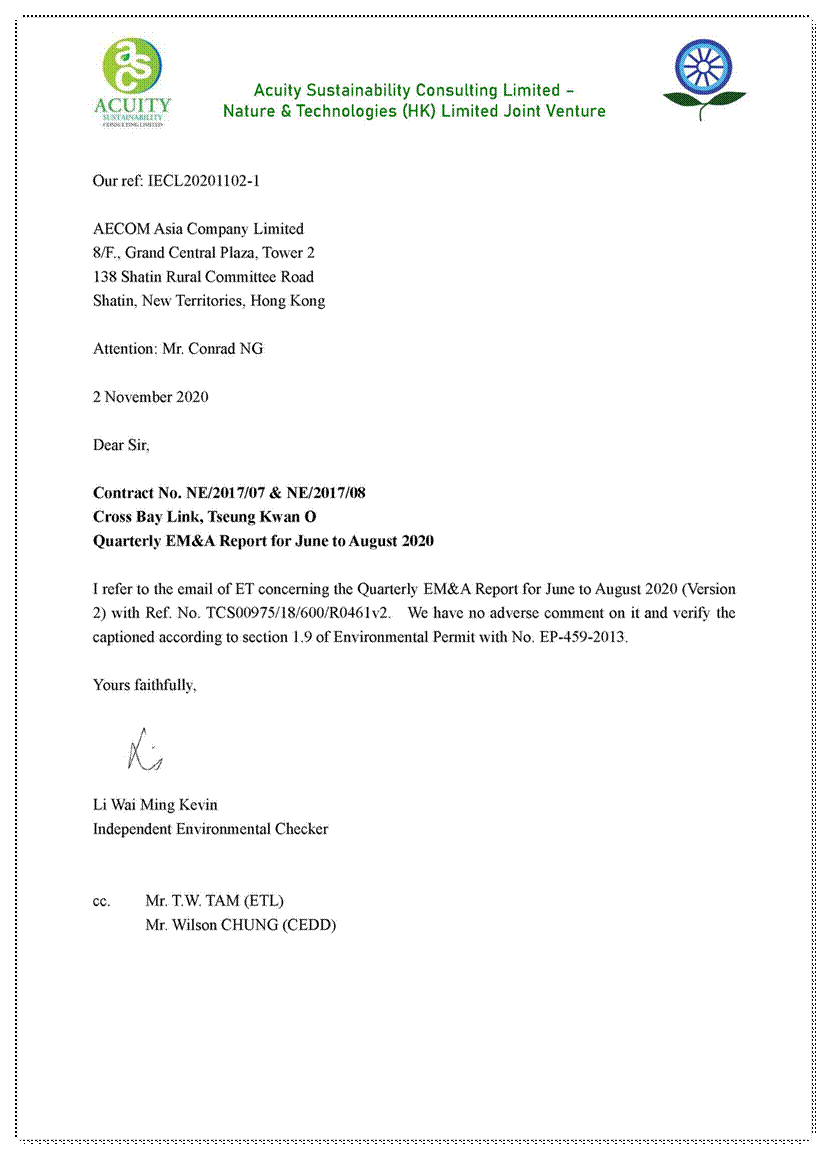

IEC¡¦s comments |
|
|
|
|
|
|
executive summary
ES01
Civil Engineering and Development Department (hereafter referred as
¡§CEDD¡¨) is the Project Proponent and the Permit Holder of the Project Cross Bay
Link, Tseung Kwan O (hereinafter referred as ¡§the
Project¡¨) which is a Designated Project to be implemented under Environmental
Permit number EP-459/2013 (hereinafter referred as ¡§the EP-459/2013¡¨ or ¡§the
EP¡¨).
ES02
AUES was awarded the CEDD Contract Agreement No. EDO/04/2018 -
Environmental Team for Cross Bay Link, Tseung Kwan O
(hereinafter called ¡§the Service Contract¡¨). The Services under the Service
Contract is to provide environmental monitoring and audit (EM&A) services
for the Works Contracts pursuant to the requirement of Environmental Team (ET)
under the Approved EM&A Manual to ensure that the environmental performance
of the Works Contracts comply with the requirement specified in the EM&A
Manual and EIA Report of Agreement No. CE 43/2008 (HY) Cross Bay Link, Tseung Kwan O - Investigation and other relevant statutory
requirements.
ES03
This
is the 7th
Quarterly EM&A report presenting the monitoring results and inspection
findings for the reporting period from 1st
June 2020 to 31st August
2020 (hereinafter ¡¥the Reporting Period¡¦).
Environmental Monitoring and Audit Activities
ES04
Environmental
monitoring activities under the EM&A program in this Reporting Period are
summarized in the following table.
Table ES-4 Summary Environmental
Monitoring Activities Undertaken in the Reporting Period
Issues |
Environmental Monitoring Parameters / Inspection |
Sessions |
|
Air Quality |
1-Hour TSP |
48 |
|
24-Hr TSP |
16 |
||
Construction Noise |
Leq (30min) Daytime |
26 |
|
Leq (5min) Evening(Note 1) |
22 |
||
Water Quality |
Marine Water
Sampling(Note 2) (Note 3) |
0 |
|
Inspection / Audit |
Contract 1 |
ET Regular
Environmental Site Inspection |
13 |
Joint site
audit with Project Consultant and IEC |
3 |
||
Contract 2 |
ET Regular
Environmental Site Inspection |
13 |
|
Joint site
audit with Project Consultant and IEC |
3 |
Note
1 Total sessions
are counted by every 3 consecutive Leq5min
Note
2 Total sessions
are counted by monitoring days
Note 3 Since the marine construction
works that requires marine water quality monitoring as stated in the EM&A
Manual were completed, the impact water quality monitoring was ceased with
effect from 1 May 2020.
Breach of Action and Limit (A/L)
Levels
ES05
No air
quality monitoring exceedance was recorded in this Reporting Period. Three (3) daytime and one (1) nighttime construction
noise action level exceedance were recorded in the reporting period. In
addition, seventeen (17) sessions of evening additional construction noise
Limit level exceedances were recorded in this Reporting Period. NOEs were
issued to notify EPD, IEC, the Contractor and the Project Consultant. The
statistics of environmental exceedance, NOE issued and investigation of
exceedance are summarized in the following table.
Table ES-5 Summary Environmental
Monitoring Parameter Exceedance in the Reporting Period
Environmental Issues |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
|
Investigation Results |
Corrective Actions |
||||
Air Quality |
1-Hour TSP |
0 |
0 |
-- |
-- |
24-Hr TSP |
0 |
0 |
-- |
-- |
|
Construction Noise |
Leq30min Daytime |
3 |
0 |
Two project related |
Although complaints are related
to the Project, however, the Contractor did not breach the CNP requirement
with use of one derrick barge on restricted hour. |
Leq5min Evening
|
0 |
17 |
Not project related |
NA |
|
Leq5min
Nighttime |
1 |
0 |
Not project related |
NA |
|
Water Quality
(Marine Water) |
DO |
0 |
0 |
-- |
-- |
Turbidity |
0 |
0 |
-- |
-- |
|
SS |
0 |
0 |
-- |
-- |
Note: NOE
¡V Notification of Exceedance
ES06
For
the evening construction noise monitoring limit level exceedances recorded in the
reporting period, investigations were carried out and it was considered that
the exceedances recorded are unlikely caused by the Project. Nevertheless, the Contractor was
reminded to strictly follow the requirement
stipulated in the applied CNP during evening works.
ES07
Five (5) environmental complaint was recorded in this Reporting Period for the
Project. The statistics of
environmental complaint are summarized in the following table.
Table ES-6 Summary Environmental
Complaint Records in the Reporting Period
Reporting Period |
Contract |
Environmental Complaint Statistics |
Related with the Works Contract(s) |
||
Frequency |
Cumulative |
Complaint Nature |
|||
1 |
4 |
9 |
Construction Dust, Light Noise and Wastewater |
Two Project Related |
|
2 |
1 |
4 |
Construction Dust |
One Project Related |
Notification of Summons and Successful Prosecutions
ES08
No environmental
summons or prosecutions was received in this Reporting Period for the
Project. The statistics of
environmental summons or prosecutions are summarized in the following tables.
Table ES-7 Summary Environmental
Summons Records in the Reporting Period
Reporting Period |
Contract |
Environmental Summons Statistics |
Related with the Works Contract(s) |
||
Frequency |
Cumulative |
Complaint Nature |
|||
1 June ¡V 31 August 2020 |
1 |
0 |
0 |
NA |
NA |
2 |
0 |
0 |
NA |
NA |
Table ES-8 Summary Environmental
Prosecutions Records in the Reporting Period
Contract |
Environmental Prosecution Statistics |
Related with the Works Contract(s) |
|||
Frequency |
Cumulative |
Complaint Nature |
|||
1
June ¡V 31 August 2020 |
1 |
0 |
0 |
NA |
NA |
2 |
0 |
0 |
NA |
NA |
Site Inspection by
External Parties
ES09
No
site inspection was undertaken by AFCD within the Reporting Period. However,
EPD inspection were undertaken on 17 July 2020 and 20 August 2020.
Table of Contents
2. Project Organization
and Construction progress and Submission
2.3 Summary of Environmental Submissions
3. Summary of
Environmental Monitoring Programmes and Requirements
3.4 Monitoring
Frequency and Period
3.5 Determination
of Action/Limit (A/L) Levels
4.1 Results
of Air Quality Monitoring in the Reporting Month
4.2 Results
of Construction Noise Monitoring
4.3 Results
of Water quality Monitoring
5.2 Records
of Waste Quantities
6.2 Findings
/ Deficiencies During the Reporting Month
7.2 Limit
Levels and Event and Action Plan
8. Environmental
Complaint and Non-Compliance
8.1 Environmental
Complaint, Summons and Prosecution
9. Implementation Status
of Mitigation Measures
10. Conclusions and Recommendations
List
of TABLES
Table 3-1 Summary
of EM&A Requirements
Table 3-2 Designated
Air Quality Monitoring Location recommended in EM&A Manual
Table 3-3 Designated
Construction Noise Monitoring Location recommended in EM&A Manual
Table 3-4 Interim
alternative location for air quality and noise monitoring
Table 3-5 Location
of Water Quality Monitoring Station
Table 3-6 Action
and Limit Levels for Air Quality
Table 3-7 Action
and Limit Levels for Construction Noise
Table 3-8 Action
and Limit Levels for Water Quality
Table 4-1 Summary
of Air Quality Impact Monitoring results
Table 4-2 Summary
of Construction Noise Impact Monitoring results
Table 4-3 Summary
of Evening Construction Noise Impact Monitoring results
Table 5-1 Summary
of Quantities of Inert C&D Materials
Table 5-2 Summary
of Quantities of C&D Wastes
Table 6-1 Summary
of Site Observations of Contract 1
Table 6-2 Summary
of Site Observations of Contract 2
Table 7-1 Actions
in the Event of Landfill Gas Being Detected in Excavations
Table 8-1 Statistical
Summary of Environmental Complaints
Table 8-2 Statistical
Summary of Environmental Summons
Table 8-3 Statistical
Summary of Environmental Prosecution
Table 9-1 Environmental
Mitigation Measures in the Reporting Period
List
of Appendices
Appendix A Project Layout Plan
Appendix B Project Organization Chart
& Contact Details of Key Personnel
Appendix C 3-Month Rolling Construction
Program
Appendix D Monitoring Location (Air
Quality, Noise and Water Quality)
Appendix E Graphical plots of Monitoring
Results
Appendix F Meteorological Information
Appendix G Waste Flow Table
Appendix H Complaint Summary
Appendix I Implementation Schedule
for Environmental Mitigation Measures (ISEMM)
1.1.1
Civil Engineering and Development Department (hereafter referred as
¡§CEDD¡¨) is the Project Proponent and the Permit Holder of the Project Cross Bay
Link, Tseung Kwan O (hereinafter referred as ¡§the
Project¡¨) which is a Designated Project to be implemented under Environmental
Permit number EP-459/2013 (hereinafter referred as ¡§the EP-459/2013¡¨ or ¡§the
EP¡¨).
1.1.2
AUES was awarded the CEDD Contract Agreement No. EDO/04/2018 -
Environmental Team for Cross Bay Link, Tseung Kwan O
(hereinafter called ¡§the Service Contract¡¨). The Services under the Service
Contract is to provide environmental monitoring and audit (EM&A) services
for the Works Contracts pursuant to the requirement of Environmental Team (ET)
under the Approved EM&A Manual to ensure that the environmental performance
of the Works Contracts comply with the requirement specified in the EM&A
Manual and EIA Report of Agreement No. CE 43/2008 (HY) Cross Bay Link, Tseung Kwan O - Investigation and other relevant statutory
requirements.
1.1.3
As part of the EM&A programme,
baseline monitoring shall be undertaken before the Project construction work
commencement to determine the ambient environmental condition. The baseline air quality, background noise
and water quality monitoring has been carried out between 21st September 2018
and 13th November 2018 at the
designated and interim locations. The baseline monitoring report under the EP-459/2013 has been compiled
by the ET and verified by Independent Environmental Checker (hereinafter the
¡§IEC¡¦) prior submitted to EPD on 19th November 2018 for
endorsement.
1.1.4
This
is the 7th
Quarterly EM&A report presenting the monitoring results and inspection
findings for the reporting period from 1st
June 2020 to 31st August
2020 (hereinafter ¡¥the Reporting Period¡¦).
1.2.1
The
Environmental Monitoring and Audit (EM&A) Monthly
Report is structured into the following sections:-
Section 1 |
Introduction |
Section 2 |
Project Organization and
Construction Progress |
Section 3 |
Summary
of Impact Monitoring Requirements |
Section 4 |
Impact
Monitoring Results |
Section 5 |
Waste
Management |
Section 6 |
Site
Inspections |
Section 7 |
Landfill Gas Monitoring |
Section 8 |
Environmental
Complaints and Non-Compliance |
Section 9 |
Implementation
Status of Mitigation Measures |
Section 10 |
Conclusions
and Recommendations |
2.1.1
The
project organization is shown in Appendix B. The responsibilities of
respective parties can be referred to Monthly Report.
2.2.1
3-month rolling construction program of each Works Contract is
enclosed in Appendix C; and the major
construction activities undertaken in the Reporting Period is presented in
below sub-sections.
Contract
1 (Contract No. NE/2017/07)
2.2.2
The major construction activities of Contract 1 undertaken in this
Reporting Period are:-
Precast shell, pile and box girder Installation at Portion II
1st and 2nd Stage of Pile caps concreting work at Portion II
Fabrication of bottom deck panels, top deck panels and diaphragm
panels at Portion II
Fabrication of arch panel at Portion II
ABWF work at Portion V
E&M installation at Portion V
Precast pier installation work at Portion II
Contract 2 (Contract
No. NE/2017/08)
2.2.3
The major construction activities of Contract 2 undertaken in this
Reporting Period are:-
Pre-bored
Socket H-Pile (Portion VI)
Excavation
(Portion VI)
Sheet
Pilling (Portion VI)
Drainage
Installation (Portion VI)
Footing
construction(Portion VI)
Excavation
& RC works (Superstructure) (Portion III)
Trimming
Bored pile head (Portion VI)
RC
construction for U-trough(Portion III)
Pavement
breaking work(Portion VI)
2.3.1
All the documents required under Environmental Permit No. EP-459/2013
were submitted within the required timeframe. The details can be referred to
the Monthly Report.
2.3.2
Upon completed baseline monitoring, a Baseline Monitoring Report was verified by IEC on 19
November 2018 and submitted to EPD on that day for endorsement.
2.3.3
The
notification of Project dedicated web site to EPD was made on 9 January 2019
(http://www.envcbltko.hk/).
3.1.1
The Environmental Monitoring and Audit Programmes
and requirements are set out in the Approved EM&A manual. Environmental issues such as air
quality, construction noise and water quality were identified as the key issues
during the construction phase of the Project. A summary of EM&A programmes and requirements are presented in the
sub-sections below.
3.2.1
Monitoring parameters of air quality, noise and water quality are
summarized in Table 3-1.
Table 3-1 Summary
of EM&A Requirements
Environmental
Issue |
Parameters |
Air Quality |
1-hour TSP by Real-Time
Portable Dust Meter; and 24-hour TSP by High Volume
Air Sampler |
Noise |
Leq (30min) in six consecutive Leq(5 min) between 07:00-19:00 on normal
weekdays Supplementary
information for data auditing, statistical results such as L10 and
L90 shall also be obtained for reference. |
Water Quality |
In-situ measurement
¡V Dissolved Oxygen (DO) concentration (mg/L) & saturation (%), pH,
Salinity (mg/L), Temperature (ºC) and Turbidity (NTU); and Laboratory analysis
¡V SS (mg/L) |
Air Quality and Construction Noise
3.3.1
According to
the Approved EM&A Manual Section 5.4
and Section 6.3, three (3) representative air sensitive receivers (ASR)
and four (4) representative noise sensitive receivers were
designated as monitoring stations.
The designated air quality and noise monitoring locations are listed in Table
3-2 and Table 3-3, and illustrated in Appendix D.
Table 3-2 Designated Air
Quality Monitoring Location recommended in
EM&A Manual
ID |
Location
in the EM&A Manual |
Currently Situation |
AM1 |
Tung Wah Group of Hospitals
Aided Primary School & Secondary School |
Not yet
construct |
AM2 |
Lohas Park Stage 2
(Planned Development in Area 86) |
Under
Construction |
AM3 |
Lohas Park Stage 3
(Planned Development in Area 86) |
Under
Construction |
Table 3-3 Designated
Construction Noise Monitoring Location recommended by
EM&A Manual
ID |
Location |
Currently Situation |
CNMS-1 |
Lohas Park Stage 1(Planned
Development in Area 86, Package 5) (Southeast facade) |
Available for
resident occupation in November 2019 |
CNMS-2 |
Lohas Park Stage 1
(Planned Development in Area 86, Package 6) (Southeast facade) |
Under
Construction |
CNMS-3 |
Lohas Park Stage 3
(Planned Development in Area 86,Package 11) (West facade) |
Under
Construction |
CNMS-4 |
Tung Wah Group of Hospitals Aided Primary School &
Secondary School (Southwest facade) |
Not yet
construct |
3.3.2
As observed and confirmed by ET and IEC during the joint site visit on 29th August 2018, the
designated air quality and noise
monitoring locations are under construction or yet to construct. It is considered that these
designated locations are not appropriate to perform air quality and noise
monitoring. In this regard, alternative locations were proposed as interim arrangement to
carry out air quality and noise monitoring before occupation of the designated
monitoring location. A letter enclosed with the alternative location proposal and
IEC verification (Our Ref: TCS00975/18/300/L0038) was sent to EPD on 19th
October 2018 and the proposal was agreed by EPD. Therefore, air
quality and construction noise impact monitoring would be performed at the
agreed alternative locations until the designated sensitive receivers occupied
and granted the premises.
3.3.3
The designated and interim alternative
monitoring location for impact air quality and
noise monitoring in the Reporting Period are summarized in Table 3-4 and illustrated in Appendix
D.
Table 3-4 Interim alternative location
for air quality and noise monitoring
Location ID |
Monitoring Parameter |
Location |
AM4 |
1-Hour TSP Air
Quality |
Podium of Lohas Park Phase 2A (Le Prestige) |
AM5 |
24-Hour TSP Air Quality |
Boundary of Site Office near Junction of Wan Po Road and Wan O Road |
CNMS-1 |
Noise (Leq, L10 & L90) |
Podium of Lohas Park Package 4 |
CNMS-5 |
Noise (Leq, L10 & L90) |
Podium of Lohas Park Phase 2A (Le Prestige) |
Remark: Since 24-Hour
TSP Air Quality monitoring is not granted at AM4 Lohas
Park Phase 2A, the 24-Hour TSP monitoring was therefore proposed at AM5 which
is located at the boundary of the project site office.
Water Quality
3.3.4
According to
Table 7.1 of the
approved EM&A Manual Section 7.4, two Control
Stations (C3 & C4), six (6) sensitive
receivers (CC1, CC2, CC3, CC4, CC13
& SWI1) and one (1) Gradient station (I1) are
recommended to perform water quality monitoring. Details and
coordinate of these water quality monitoring stations are described in Table
3-5 and the locations is shown in Appendix D.
Table 3-5 Location of Water Quality
Monitoring Station
Station |
Coordinates |
Description |
|
Easting |
Northing |
||
CC1 |
843201 |
816416 |
Sensitive
Receiver ¡V Coral
Sites at Chiu Keng Wan |
CC2 |
844076 |
817091 |
Sensitive
Receiver ¡V
Coral Sites at Junk Bay |
CC3 |
844606 |
817941 |
Sensitive
Receiver ¡V
Coral Sites at Junk Island |
CC4 |
845444 |
815595 |
Sensitive
Receiver ¡V Coral
Sites at Fat Tong Chau West |
CC13 |
844200 |
817495 |
Sensitive Receiver ¡V Coral Sites at Junk Bay
near Chiu Keng Wan |
SWI1 |
845512 |
817442 |
Sensitive
Receiver ¡V Tseung Kwan O Salt Water Intake |
C3 |
843821 |
816211 |
Control Station (Ebb Tide) ¡V within Junk Bay |
C4 |
844621 |
815770 |
Control Station (Flood Tide) ¡V within Junk Bay |
I1 |
844602 |
817675 |
Gradient Station ¡V in between Lam Tin Tunnel (LTT) and CBL |
3.4.1
To according with the approved EM&A Manual, impact monitoring requirements are presented as
follows.
Air Quality Monitoring
3.4.2
Air quality impact monitoring frequency is
as follows:
Once every 6 days of 24-hour TSP and 3 times of 1-hour TSP monitoring; during course of works throughout the construction period
Construction Noise Monitoring
3.4.3
Construction noise monitoring frequency is
as follows:
One set of Leq(30min) measurements in a weekly basis
between 07:00 and 19:00 hours on normal weekdays during course of works as throughout the construction period
If construction works are
extended to include works during the hours of 1900-0700, additional weekly
impact monitoring shall be carried out during evening and night-time works.
Applicable permits under the NCO shall be obtained by the Contractor.
Water Quality (Marine Water) Monitoring
3.4.4
Marine water impact monitoring frequency
is as follows:
Three days a week, at mid ebb and mid flood
tides during
course of pile excavation works for the bridge pier foundations underway. Moreover, the intervals
between 2 consecutive sets of monitoring day shall not be less than 36 hours.
3.5.1
The baseline results form the basis for determining the
environmental acceptance criteria for the impact monitoring. A summary of the Action/Limit (A/L)
Levels for air quality, construction noise and water quality are shown in Tables
3-6, 3-7 and 3-8 respectively.
Table
3-6 Action & Limit Levels of Air
Quality (1-Hour & 24-Hr TSP)
Monitoring Station |
Action Level (mg /m3) |
Limit Level (mg/m3) |
||
1-Hour TSP |
24-Hr TSP |
1-Hour TSP |
24-Hr TSP |
|
AM4 |
278 |
NA |
500 |
NA |
AM5 |
NA |
190 |
NA |
260 |
Note: 1-Hour
& 24-Hr TSP of Action Level = (Average
Baseline Results ¡Ñ 1.3 + Limit
level)/2 |
Table 3-7 Action
and Limit Levels for Construction Noise, dB(A)
Monitoring Location |
Action Level |
Limit Level (Leq30min) |
Time Period: 0700-1900 hours
on normal weekdays |
||
CNMS-1 |
When
one or more documented complaints are received |
75 dB(A) |
CNMS-5 |
||
Remarks: 1.
Construction noise monitoring
will be resumed at the designated locations CNMS-2, CNMS-3 and CNMS4 once
they are available and permission are granted; 2.
The designated locations
CNMS-2 and CNMS-3 are located at residential building which are still under construction, Limit
Level of 75dB(A) will be adopted until they are occupied; 3.
The designated location
CNMS-4 is located at
planned school and still not yet to construction. When the school occupied and operated, Limit Level of 70dB(A) should be
adopted and should be reduced to 65dB(A) during examination period; and 4.
If
construction works are required during restricted hours, the conditions
stipulated in the construction noise permit issued by the
Noise Control Authority shall be followed. |
Table
3-8 Action
and Limit Levels for Water Quality
Monitoring Station |
Depth Average of SS (mg/L) |
|||||
Action Level |
Limit Level |
|||||
CC1 |
7.8 |
OR
120% of upstream control station at the same tide of the same day (Control Station C3 at Ebb tide and Control Station C4 at Flood tide),
whichever is higher |
9.3 |
OR
130% of upstream control station at the same tide of the same day (Control Station C3 at Ebb tide and Control Station C4 at Flood tide)
, whichever is higher |
||
CC2 |
9.0 |
9.2 |
||||
CC3 |
8.2 |
9.0 |
||||
CC4 |
13.8 |
15.4 |
||||
CC13 |
8.9 |
10.3 |
||||
SWI1 |
8 mg/L |
10 mg/L |
||||
|
||||||
Monitoring Location |
Dissolved
Oxygen (mg/L) |
|||||
Depth
Average of Surface and Mid-depth |
Bottom |
|||||
Action
Level |
Limit Level |
Action
Level |
Limit Level |
|||
CC1 |
5.8 |
5.7 |
5.3 |
5.2 |
||
CC2 |
5.8 |
5.7 |
5.3 |
5.1 |
||
CC3 |
5.5 |
5.4 |
4.9 |
4.7 |
||
CC4 |
5.7 |
5.7 |
5.5 |
5.4 |
||
CC13 |
5.6 |
5.5 |
5.3 |
5.2 |
||
SWI1 |
5.4 |
4.8 |
5.1 |
5.0 |
||
|
||||||
Monitoring Location |
Depth Average of Turbidity (NTU) |
|||||
Action Level |
Limit Level |
|||||
CC1 |
5.8 |
OR
120% of upstream control station at the same tide of the same day (Control Station C3 at Ebb tide and Control Station C4 at Flood tide)
, whichever is higher |
6.0 |
OR
130% of upstream control station at the same tide of the same day (Control Station C3 at Ebb tide and Control Station C4 at Flood tide)
, whichever is higher |
||
CC2 |
4.6 |
5.5 |
||||
CC3 |
4.8 |
5.4 |
||||
CC4 |
6.1 |
7.1 |
||||
CC13 |
6.0 |
6.3 |
||||
SWI1 |
6.1 |
7.1 |
||||
3.5.2
Should
non-compliance of the environmental quality criteria occurs, remedial actions will
be triggered according to the Event and Action Plan as stated EM&A Manual.
4.1.1
During the Reporting Period, 48 sessions of 1-hour TSP and 16 sessions of 24-hours TSP monitoring were carried out and the monitoring
results are summarized in Table 4-1. The relevant graphical plots are shown in Appendix E.
Table 4-1 Summary
of Air Quality Impact Monitoring Results
Monitoring Location |
1-hour TSP (µg/m3) |
24-hour TSP (µg/m3) |
||||
Min |
Max |
Average |
Min |
Max |
Average |
|
AMS-4 |
38 |
83 |
67 |
|
||
Record Date |
31-Jul-20 |
14-Jul-20 |
48 events |
|||
AMS-5 |
|
20 |
97 |
56 |
||
Record Date |
7-Jul-20 |
28-Aug-20 |
16 events |
4.1.2
As
shown in Table 4-1, all the 1-hour TSP and 24-hour TSP monitoring
results were below the Action / Limit Levels. No Notification of Exceedance (NOE) was
issued in this Reporting Period.
4.1.3
No adverse impact due to weather condition on the monitoring result
was observed in reporting quarter. The summary of meteorological information
for the Reporting Period is shown in Appendix F.
4.2.1
13
sessions of daytime construction noise monitoring and 11 sessions of evening construction noise monitoring were performed
at the designated location CNMS-1 in the reporting period; and 13 sessions of daytime construction noise monitoring and 11 sessions of evening
construction noise monitoring were performed at the interim alternative location
CNMS-5 in the reporting period. The
noise monitoring results at designated location CNMS-1 and interim alternative
monitoring location CNMS-5 are summarized in Table 4-2 and
Table 4-3. The relevant graphical plots are shown in Appendix E.
Table 4-2 Summary
of Daytime Construction Noise Impact Monitoring Results
Monitoring Location |
Leq, 30min (dB((A)) |
||
Min |
Max |
Average |
|
CNMS-1 |
63.9 |
70.5 |
67.8 |
Record Date |
31-Jul-20 |
|
