|
|
|
||||
|
|
|
||||
|
|
|
||||
|
|
Job
No.: TCS00975/18 |
|
|
||
|
|
|
|
|
||
|
|
CEDD Contract Agreement No.
EDO/04/2018 - Environmental Team for Cross Bay Link, Tseung Kwan O |
|
|
||
|
|
|
|
|
||
|
|
Monthly
Environmental Monitoring & Auditing Report of the Project ¡V April 2021 |
|
|
||
|
|
Prepared For |
|
|
||
|
|
Civil Engineering and Development Department (CEDD) |
|
|
||
Date |
Reference No. |
Prepared By |
Certified By |

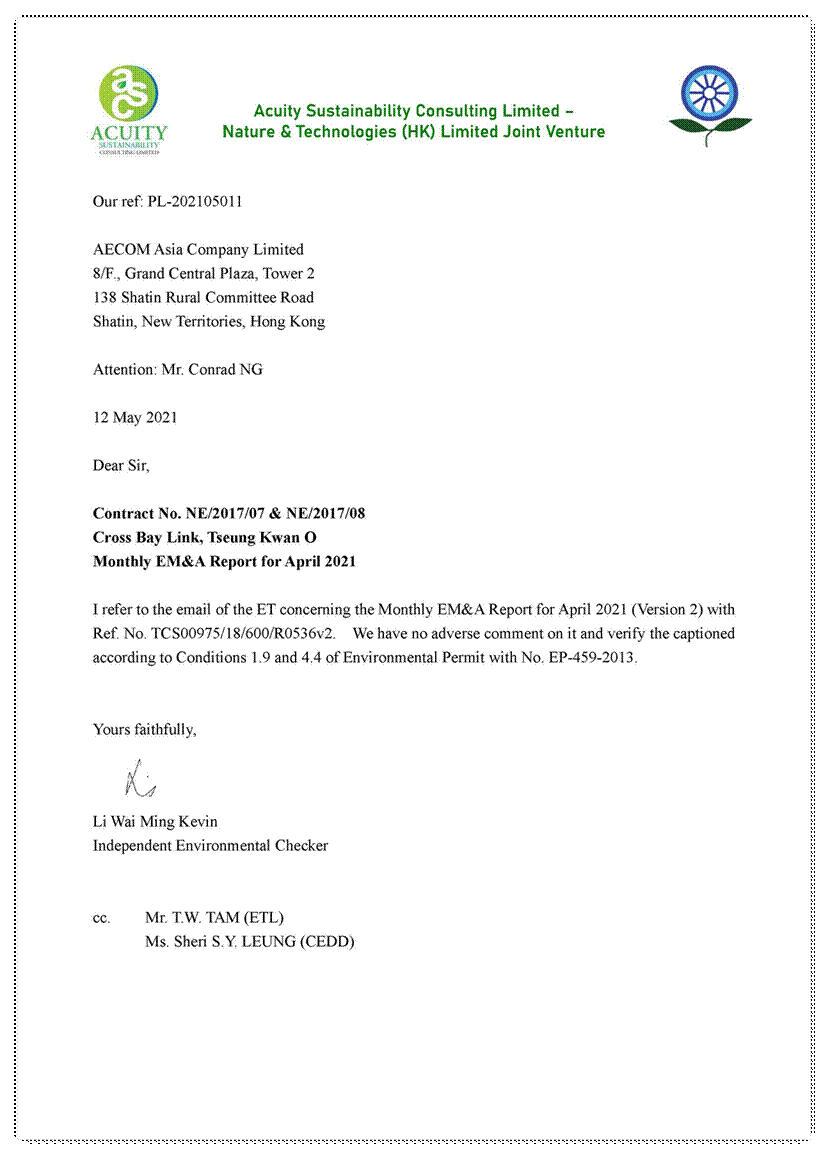

12 May 2021 |
TCS00975/18/600/R0536v2 |
|
|
Martin Li (Environmental Consultant) |
Tam Tak Wing (Environmental
Team Leader) |
Version |
Date |
Remarks |
1 |
11 May 2021 |
First Submission |
2 |
12
May 2021 |
Amended against
IEC¡¦s comments |
|
|
|
|
|
|
executive summary
ES01
Civil Engineering and Development Department (hereafter referred as
¡§CEDD¡¨) is the Project Proponent and the Permit Holder of the Project Cross Bay
Link, Tseung Kwan O (hereinafter referred as ¡§the
Project¡¨) which is a Designated Project to be implemented under Environmental
Permit number EP-459/2013 (hereinafter referred as ¡§the EP-459/2013¡¨ or ¡§the
EP¡¨).
ES02
AUES was awarded the CEDD Contract Agreement No. EDO/04/2018 -
Environmental Team for Cross Bay Link, Tseung Kwan O
(hereinafter called ¡§the Service Contract¡¨). The Services under the Service
Contract is to provide environmental monitoring and audit (EM&A) services
for the Works Contracts pursuant to the requirement of Environmental Team (ET)
under the Approved EM&A Manual to ensure that the environmental performance
of the Works Contracts comply with the requirement specified in the EM&A
Manual and EIA Report of Agreement No. CE 43/2008 (HY) Cross Bay Link, Tseung Kwan O - Investigation and other relevant statutory
requirements.
ES03
To facilitate management, the proposed Works of the project was divided into two Civil Engineering and Development Department (CEDD) Works contracts
included Contract 1 (Contract No. NE/2017/07) and Contract 2 (Contract No. NE/2017/08). The date for
commencement of Contract 1 was 3rd December 2018 while the
date for commencement of Contract 2 was 17th January 2019.
ES04
According to the Approved Environmental Monitoring &
Audit (EM&A) Manual, air quality, noise and water quality
monitoring are required to be
conducted during the construction phase of the Project. As part of the EM&A programme, baseline monitoring shall undertake before the
Project construction work commencement to determine the
ambient environment condition. The baseline air quality,
background noise and water quality monitoring has been carried out between 21st September 2018
and 13th November 2018 at the
designated and interim locations. The baseline monitoring report under the EP-459/2013 has been compiled
by the ET and verified by Independent Environmental Checker (hereinafter the
¡§IEC¡¦) prior submitted to EPD on 19th November 2018 for
endorsement.
ES05
This
is the 29th
Monthly EM&A report presenting the monitoring results and inspection findings
for the reporting period from 1st to 30th
April 2021 (hereinafter ¡¥the Reporting Period¡¦).
Construction works conducted
at the reporting month
ES06
The major construction activities of Contract 1 (Contract No. NE/2017/07)
undertaken in this Reporting Period are:-
Predrilling,
Pilling Work at Portion I
Precast Pier and box girder installation at Portion II
Stage Concrete for pile caps at portion II
ABWF works, E&M Work and External Work at Portion V Plant
Room Building
1, 2, 3 and 4 round arch rib segment assembly
Precast ¡V Pier fabrication for Pier W5
ES07
The major construction activities of Contract 2 (Contract No. NE/2017/08) undertaken
in this Reporting Period are:-
Excavation (Portion III,VI)
Drainage Installation (Portion VI)
Footing construction(Portion VI)
Excavation & RC works (Superstructure) (Portion III)
RC construction for U-trough(Portion III)
Seawall modification
ELS & manhole construction at SMH012 &SMH011
Noise barrier installation(Portion VI)
Environmental Monitoring and Audit Activities
ES08
Environmental
monitoring activities under the EM&A program in this Reporting Period are
summarized in the following table.
Table ES-4 Summary
Environmental Monitoring Activities Undertaken in the
Reporting Period
Issues |
Environmental Monitoring Parameters / Inspection |
Sessions |
|
Air Quality |
1-Hour TSP |
42 |
|
24-Hr TSP |
6 |
||
Construction Noise |
Leq (30min) Daytime |
15 |
|
Leq (5min) Evening(Note 1) |
0 |
||
Water Quality |
Marine Water
Sampling(Note 2) (Note 3) |
0 |
|
Inspection / Audit |
Contract 1 |
ET Regular
Environmental Site Inspection |
4 |
Joint site
audit with Project Consultant and IEC |
1 |
||
Contract 2 |
ET Regular
Environmental Site Inspection |
4 |
|
Joint site
audit with Project Consultant and IEC |
1 |
Note
1 Total sessions are
counted by every 3 consecutive Leq5min
Note
2 Total sessions
are counted by monitoring days
Note 3 Since the marine construction
works that requires marine water quality monitoring as stated in the EM&A
Manual were completed, the impact water quality monitoring was ceased with
effect from 1 May 2020.
Breach of Action and Limit (A/L)
Levels
ES09
No air
quality monitoring exceedance was recorded in this Reporting Period. For
construction noise monitoring, one noise complaint (which triggered Action
Level) was recorded in this Reporting Period. The statistics of environmental
exceedance and investigation of exceedance are summarized in the following
table.
Table ES-5 Summary Environmental
Monitoring Parameter Exceedance in the Reporting Period
Environmental Issues |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
|
Investigation Results |
Corrective Actions |
||||
Air Quality |
1-Hour TSP |
0 |
0 |
-- |
-- |
24-Hr TSP |
0 |
0 |
-- |
-- |
|
Construction Noise |
Leq30min Daytime |
1 |
0 |
Under Investigation |
To be provided in next
report. |
Leq5min Evening |
0 |
0 |
-- |
-- |
|
Water Quality
(Marine Water) |
DO |
0 |
0 |
-- |
-- |
Turbidity |
0 |
0 |
-- |
-- |
|
SS |
0 |
0 |
-- |
-- |
Environmental Complaint
ES10
In the reporting period, two (2) environmental complaints
were recorded for the Project. The statistics of environmental complaint are
summarized in the following table.
Table ES-6 Summary Environmental
Complaint Records in the Reporting Period
Reporting Period |
Contract |
Environmental Complaint Statistics |
Related with the Works Contract(s) |
||
Frequency |
Cumulative |
Complaint Nature |
|||
1 |
0 |
16 |
NA |
NA |
|
2 |
2 |
11 |
Water |
Not Project Related |
|
Noise |
Under Investigation |
Notification of Summons and Successful Prosecutions
ES11
No
environmental summons or prosecutions was received in this Reporting Period for
the Project. The statistics of
environmental summons or prosecutions are summarized in the following tables.
Table ES-7 Summary Environmental
Summons Records in the Reporting Period
Reporting Period |
Contract |
Environmental Summons Statistics |
Related with the Works Contract(s) |
||
Frequency |
Cumulative |
Complaint Nature |
|||
1 ¡V 30 April 2021 |
1 |
0 |
0 |
NA |
NA |
2 |
0 |
0 |
NA |
NA |
Table ES-8 Summary Environmental
Prosecutions Records in the Reporting Period
Contract |
Environmental Prosecution Statistics |
Related with the Works Contract(s) |
|||
Frequency |
Cumulative |
Complaint Nature |
|||
1
¡V 30 April 2021 |
1 |
0 |
0 |
NA |
NA |
2 |
0 |
0 |
NA |
NA |
Reporting Change
ES12
There is no reporting change made for this monthly report.
Site Inspection by
External Parties
ES13
No
site inspection was undertaken by AFCD within the Reporting Period. EPD
inspection was undertaken on 13, 22 and 28 April 2021.
ES14
Due to wet season has approached, the Contractor was reminded that
all the works being undertaken must fulfill environmental statutory
requirements and to paid attention to water quality mitigation measures to
prevent surface runoff into nearby water bodies or public areas.
ES15
Construction noise would be the key environmental issue as Lohas Park Phase 4 & 6 were
already available for resident occupation. The noise mitigation measures such
as use of quiet plants and installation of temporary noise barrier at the
construction noise predominate area should be fully implemented in accordance
with the EM&A requirement.
Table of Contents
2. Project Organization and Construction
progress and Submission
2.3 Summary of Environmental Submissions
3. Summary of Environmental Monitoring
Programmes and Requirements
3.4 Monitoring
Frequency and Period
3.7 Determination
of Action/Limit (A/L) Levels
3.8 Data
Management and Data QA/QC Control
4.2 Results
of Air Quality Monitoring in the Reporting Month
5. Construction Noise Monitoring
5.2 Results
of Noise Monitoring
7.2 Records
of Waste Quantities
8.2 Findings
/ Deficiencies During the Reporting Month
8.3 Implementation
Status of Surface Runoff Mitigation Measures
9.2 Limit
Levels and Event and Action Plan
10. Environmental Complaint and Non-Compliance
10.1 Environmental
Complaint, Summons and Prosecution
11. Implementation Status of Mitigation Measures
11.2 Tentative
Construction Activities in the Coming Month
12. Conclusions and Recommendations
List of TABLES
Table
2-1 Documents
Submission under Environmental Permit Requirement
Table
2-2 Status
of Environmental Licenses and Permits of the Project Works (Contract 1)
Table
2-3 Status
of Environmental Licenses and Permits of the Project Works (Contract 2)
Table
3-1 Summary
of EM&A Requirements
Table
3-2 Designated
Air Quality Monitoring Location recommended in EM&A Manual
Table
3-3 Designated
Construction Noise Monitoring Location recommended in EM&A Manual
Table
3-4 Designated
and interim alternative location for air quality and noise monitoring in the
Reporting Period
Table
3-5 Location
of Water Quality Monitoring Station
Table
3-6 Air
Quality Monitoring Equipment
Table
3-7 Construction
Noise Monitoring Equipment
Table
3-8 Water
Monitoring Equipment
Table
3-9 Testing
Method and Reporting Limit of the Chemical Analysis
Table
3-10 Action
and Limit Levels for Air Quality
Table
3-11 Action
and Limit Levels for Construction Noise
Table
3-12 Action
and Limit Levels for Water Quality
Table
4-1 1-Hour
TSP Air Quality Impact Monitoring results for AM4 and 24-Hour TSP Air Quality
Impact Monitoring results for AM5
Table
4-2 1-Hour
TSP Air Quality Impact Monitoring results for AM2
Table
5-1 Daytime
Construction Noise Impact Monitoring results at CNMS-1
Table
5-2 Daytime
Construction Noise Impact Monitoring results at CNMS-2
Table
5-3 Daytime
Construction Noise Impact Monitoring results at CNMS-5
Table
7-1 Summary
of Quantities of Inert C&D Materials
Table
7-2 Summary
of Quantities of C&D Wastes
Table
8-1 Site
Observations of Contract 1
Table
8-2 Site
Observations of Contract 1
Table
9-1 Actions
in the Event of Landfill Gas Being Detected in Excavations
Table
9-2 Summary
of Landfill Gas Measurement Results
Table
10-1 Statistical
Summary of Environmental Complaints
Table
10-2 Statistical
Summary of Environmental Summons
Table
10-3 Statistical
Summary of Environmental Prosecution
Table
11-1 Environmental
Mitigation Measures in the Reporting Month
List of Appendices
Appendix A Project Layout
Plan
Appendix B Project
Organization Chart & Contact Details of Key Personnel
Appendix C 3-Month
Rolling Construction Program
Appendix D Monitoring Location
(Air Quality, Noise and Water Quality)
Appendix E Event and
Action Plan
Appendix F Impact
Monitoring Schedule of the Reporting Month and Coming Month
Appendix G Calibration
Certificates of Equipment and the Accreditation Laboratory Certificate
Appendix H Database of Monitoring
Results
Appendix I Graphical
plots of Monitoring Results
Appendix J Meteorological
Data
Appendix K Waste Flow
Table
Appendix L Implementation
Record of Water Mitigation Measures in the Reporting Month
Appendix M Implementation
Schedule for Environmental Mitigation Measures (ISEMM)
1.1.1
Civil Engineering and Development Department (hereafter referred
as ¡§CEDD¡¨) is the Project Proponent and the Permit Holder of the Project Cross
Bay Link, Tseung Kwan O (hereinafter referred as ¡§the
Project¡¨) which is a Designated Project to be implemented under Environmental
Permit number EP-459/2013 (hereinafter referred as ¡§the EP-459/2013¡¨ or ¡§the
EP¡¨).
1.1.2
AUES was awarded the CEDD Contract Agreement No. EDO/04/2018 -
Environmental Team for Cross Bay Link, Tseung Kwan O
(hereinafter called ¡§the Service Contract¡¨). The Services under the Service
Contract is to provide environmental monitoring and audit (EM&A) services
for the Works Contracts pursuant to the requirement of Environmental Team (ET)
under the Approved EM&A Manual to ensure that the environmental performance
of the Works Contracts comply with the requirement specified in the EM&A
Manual and EIA Report of Agreement No. CE 43/2008 (HY) Cross Bay Link, Tseung Kwan O - Investigation and other relevant statutory
requirements.
1.1.3
To facilitate management, the proposed Works of Cross
Bay Link, Tseung Kwan O (hereinafter
called ¡§the Project¡¦) was divided into two Civil
Engineering and Development Department (CEDD) Works contracts
included Contract 1 (Contract No. NE/2017/07) and Contract
2 (Contract No. NE/2017/08). The details of each contract Works
are summarized below and the
delineation of each contract is shown in Appendix A.
Contract 1 (Contract No. NE/2017/07)
(i)
400m section of marine viaducts
of steel deck sections including the Eternal Arch Bridge;
(ii)
600m section of marine viaducts
of concrete deck sections;
(iii)
An E&M Plantroom and
associated building services; and
(iv)
E&M provisions.
Contract
2 (Contract No. NE/2017/08)
(i)
Elevated deck structures along Road D9;
(ii)
A 210m section of cycle track and footpath ramp bridge;
(iii)
A 630m section of noise semi-enclosure covering the
entire length of Road D9, and;
(iv)
Lift, staircase, modification
of existing seawall along Road D9, landscaping and miscellaneous works.
1.1.4
The date for commencement of Contract 1 is 3rd
December 2018 while the date for commencement of Contract 2 is 17th
January 2019.
1.1.5
As part of the EM&A programme,
baseline monitoring shall be undertaken before the Project construction work
commencement to determine the ambient environmental condition. The baseline air quality, background noise
and water quality monitoring has been carried out between 21st September 2018
and 13th November 2018 at the
designated and interim locations. The baseline monitoring report under the EP-459/2013 has been compiled
by the ET and verified by Independent Environmental Checker (hereinafter the
¡§IEC¡¦) prior submitted to EPD on 19th November 2018 for
endorsement.
1.1.6
This
is the 29th
Monthly EM&A report presenting the monitoring results and inspection
findings for the reporting period from 1st to 30th
April 2021 (hereinafter ¡¥the Reporting Period¡¦).
1.2.1
The
Environmental Monitoring and Audit (EM&A) Monthly
Report is structured into the following sections:-
Section 1 |
Introduction |
Section 2 |
Project Organization and
Construction Progress |
Section 3 |
Summary
of Impact Monitoring Requirements |
Section 4 |
Air
Quality Monitoring |
Section 5 |
Construction
Noise Monitoring |
